Maximizing Project Success with Earned Value Management Techniques

In today’s dynamic and competitive business environment, organizations are under constant pressure to deliver projects on time, within scope, and under budget. Earned Value Management (EVM) has emerged as a critical project management technique to monitor progress, control costs, and ensure project success. This article explores the key principles of EVM, the tools used, and practical methodologies for implementing these techniques effectively.

What Is Earned Value Management (EVM)?

EVM is a project management methodology that integrates cost, schedule, and scope to assess project performance and forecast future outcomes.  By comparing planned progress (Planned Value or PV) with actual progress (Earned Value or EV) and costs (Actual Cost or AC), EVM offers key insights into whether a project is on track or veering off course. By comparing the planned progress with the actual progress, EVM enables project managers to identify variances and take corrective actions promptly.

Key Components of EVM

Earned Value Management (EVM) relies on several key components that allow project managers to monitor, control, and forecast project performance. These components help in comparing planned versus actual project metrics, providing insights into cost and schedule efficiency. Below are the critical elements of EVM:

1. Planned Value (PV):
Planned Value represents the budgeted cost of work scheduled to be completed by a specific point in time. It is essentially the project’s cost baseline that outlines the planned progress and budgeted costs. By comparing PV to the Earned Value (EV) and Actual Cost (AC), project managers can determine if the project is ahead, behind, or on track with respect to its schedule and budget.

2. Earned Value (EV):
Earned Value is the budgeted cost of the work that has actually been completed by the specific point in time. Unlike PV, which represents the scheduled work, EV reflects the value of the work that has been completed in terms of its planned cost. Comparing EV to PV and AC helps evaluate whether the project is progressing according to plan and if costs are under or over budget.

3. Actual Cost (AC):
Actual Cost is the real expenditure incurred for the completed work up to the current point. This metric captures all actual costs, including labor, materials, and other expenses related to the work completed. When comparing AC to EV, project managers can determine if the project is overspending or under budget for the completed work.

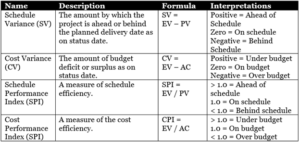

Performance Indices

EVM includes performance indices that allow project managers to assess cost and schedule efficiency, ensuring the project remains on track.

1. Cost Performance Index (CPI):
The Cost Performance Index is a measure of cost efficiency on the project. It is calculated by dividing Earned Value (EV) by Actual Cost (AC):

  • CPI = EV / AC
    A CPI greater than 1 indicates that the project is under budget, while a CPI less than 1 suggests the project is over budget. This metric helps project managers assess whether the project is spending efficiently or requires corrective actions to control costs.

2. Schedule Performance Index (SPI):
The Schedule Performance Index is a measure of schedule efficiency, calculated by dividing Earned Value (EV) by Planned Value (PV):

  • SPI = EV / PV
    An SPI greater than 1 indicates that the project is ahead of schedule, while an SPI less than 1 signals that the project is behind schedule. SPI helps in identifying whether the project is progressing at the expected rate or if adjustments are needed to meet deadlines.



Forecasting Metrics

EVM also includes metrics that help in forecasting the future performance of a project, assisting in proactive project management and adjustments.

1. Estimate at Completion (EAC):

Estimate at Completion (EAC) represents the projected total cost of the project based on its current performance. It is used to forecast the expected final cost of the project by factoring in current cost performance. The formula to calculate EAC depends on the situation, but one common formula is:

The most common way to determine EAC is a “bottoms-up” formula where the actual costs (AC) are added to the forecasted remaining spending – the estimate to complete (ETC).

EAC = actual costs (AC) + estimate to complete (ETC)

For one-time variances: If the project has encountered a one-time (atypical) variance, the following formula may be used:

EAC = actual costs (AC) + budget at completion (BAC) – earned value (EV)

For recurring variances: If the project has encountered a variance that is expected to recur and continue to affect the project (typical), the following formula may be used:

EAC = budget at completion (BAC) ÷ cost performance index (CPI)

This method accounted for ongoing performance trends, using the Cost Performance Index (CPI) to adjust the budget.

2. Estimate to Complete (ETC):

Estimate to Complete (ETC) is a forecasting metric used in Earned Value Management (EVM) to predict the remaining cost required to complete a project. It calculates the estimated cost needed to finish all the remaining work based on the current performance trends. The ETC is crucial for understanding how much more funding or resources will be required to complete the project. The formula for computing ETC varies depending on the project’s performance and the cause of any variances. One common method of calculating ETC is:

ETC = (BAC – EV) / CPI, where BAC is the Budget at Completion and EV is the Earned Value, while CPI is the Cost Performance Index. This formula assumes that the project’s cost performance will continue at the same rate as it has up to the current point. Alternatively, if the project’s cost performance is expected to change, another formula such as ETC = AC + (BAC – EV) may be used to account for revised projections. ETC provides valuable insight for project managers, helping them identify whether additional resources or adjustments are needed to keep the project within budget.

3. Variance at Completion (VAC):

Variance at Completion (VAC) is the expected difference between the original budget and the estimated total cost at completion. It helps in assessing whether the project is likely to exceed its budget. The formula to calculate VAC is:

  • VAC = Budget at Completion (BAC) – EAC
    A positive VAC indicates the project will likely finish under budget, while a negative VAC suggests the project will exceed the planned budget.

These key components of EVM form the foundation for effective project tracking, cost management, and performance forecasting. By utilizing these metrics, project managers can proactively control project outcomes, make informed decisions, and optimize resources for successful project delivery.

Tools for EVM Implementation

Implementing Earned Value Management (EVM) requires specialized tools that can efficiently track project performance, integrate data, and provide actionable insights. Several software solutions are specifically designed to simplify the application of EVM, enhancing project monitoring, control, and decision-making.

1. Primavera P6:

Primavera P6 is a leading project management tool for planning, scheduling, and monitoring large-scale projects. It integrates EVM metrics directly into its project tracking features, allowing for the detailed analysis of project performance. The software’s advanced scheduling capabilities, coupled with its ability to handle complex data, make it ideal for industries such as construction, aerospace, and engineering, where strict adherence to timelines and budgets is crucial.

2. Microsoft Project:

Microsoft Project offers built-in EVM capabilities such as task tracking, cost baselines, and visual dashboards to compare planned versus actual performance. The platform allows users to monitor and report on the Earned Value, Planned Value, and Actual Cost in a straightforward manner, making it easy to assess project health. It is well-suited for both small and large projects, providing project managers with an intuitive interface for tracking costs and schedules.

3. Deltek Cobra:

Deltek Cobra is a specialized tool for EVM reporting and compliance. It is designed to streamline data integration, analysis, and reporting for complex projects. Deltek Cobra excels in managing earned value data, enabling detailed tracking of performance against the baseline. Its robust reporting features help project managers ensure that they are meeting performance, cost, and schedule goals while maintaining compliance with industry standards and regulations.

4. Cost Estimation Tools:

  • Oracle Crystal Ball: This tool is useful for advanced cost and risk analysis by incorporating Monte Carlo simulations. It helps project managers forecast the probability of meeting cost and schedule targets under various scenarios, improving decision-making by providing a clearer understanding of potential risks.
  • Procore: Procore specializes in real-time project cost tracking and budget forecasting. It integrates with other project management software, helping to ensure that project costs remain within the established budget while providing a platform for team collaboration and cost adjustments.

5. Dashboards and Reporting Tools:

  • Tableau and Power BI: Business intelligence tools like Tableau and Power BI can be leveraged to visualize EVM metrics in a user-friendly way. These platforms enable project managers to create customized dashboards that make it easier to identify trends, anomalies, and performance issues. Visualizing EVM data helps stakeholders at all levels of the project to quickly understand the project’s status and make data-driven decisions.

By using these tools, project managers can automate data collection, enhance reporting capabilities, and improve the accuracy of their forecasts. Whether for construction, IT, or defense projects, these EVM tools provide the necessary functionality to track performance, control costs, and ultimately drive project success.

Methodologies to Apply EVM

1. Baseline Planning and Approval:

The first critical step in applying Earned Value Management (EVM) is establishing a clear and detailed project baseline. This baseline should encompass the planned costs, schedules, and key milestones.  It acts as a reference point for all EVM calculations, allowing project managers to compare actual progress against initial plans. The baseline provides a structured framework that guides performance assessment and ensures the project stays aligned with its objectives.

However, in practice, gaining approval for a baseline involves collaboration with multiple stakeholders, aligning expectations, and managing trade-offs. Practical steps include:

  • Breakdown Structures: Create detailed Work Breakdown Structures (WBS) to link specific deliverables to tasks and budgets.
  • Clear Milestones: Define realistic, measurable milestones to facilitate tracking.
  • Baseline Lockdown: Ensure that any changes to the baseline are strictly managed through a formal change control process.

2. Real-Time Data Collection and Integration:

For EVM to be effective, accurate and consistent data collection is essential. Project managers need to continuously track progress, including work completion, incurred costs, and resource utilization. This data forms the foundation for calculating key EVM metrics like Earned Value (EV), Planned Value (PV), and Actual Cost (AC). Collecting this data regularly ensures that EVM provides real-time insights into the project’s health, enabling quick responses to deviations.

Practical measures include:

  • Automated Data Feeds: Use tools like Primavera P6 or Microsoft Project to sync real-time updates from teams.
  • Standardized Reporting Templates: Establish templates for consistent reporting of work progress and costs across all teams.
  • Frequent Updates: Encourage daily or weekly updates to ensure timely performance assessments.

3. Variance Analysis:

Variance analysis is one of the core components of EVM. It helps identify the root causes of deviations in cost and schedule, allowing project managers to take corrective action. For example, Cost Variance (CV) is calculated by subtracting Actual Cost (AC) from Earned Value (EV), while Schedule Variance (SV) compares Earned Value (EV) to Planned Value (PV). Analyzing these variances provides insights into where the project is performing well and where adjustments may be necessary.

In practice, it’s essential to define thresholds that trigger corrective action. For example:

  • Set cost variance thresholds (e.g., 5-10%) to identify when budgets are at risk.
  • Use Schedule Performance Index (SPI) to flag delays and reschedule tasks proactively.
  • Involve project stakeholders immediately when variances exceed predefined thresholds.

4. Forecasting:

EVM also offers the ability to forecast future project performance based on current trends. Key forecasting metrics such as the Cost Performance Index (CPI) and Schedule Performance Index (SPI) can help predict the project’s future costs and schedule adherence. For instance, the Estimate at Completion (EAC) can be derived by dividing the total project budget by the CPI, providing an updated estimate of the project’s cost by its completion. Additionally, the To Complete Performance Index (TCPI) gives insight into the required future performance to meet the project’s financial goals, and it’s calculated by dividing the remaining work by the remaining budget.

In real-world scenarios, forecasting is a critical but challenging task. Incorporating historical project data, CPI trends, and expert judgment ensures more accurate predictions of total project costs. Practical approaches include:

  • Using predictive algorithms in tools like Deltek Cobra or Power BI.
  • Conducting sensitivity analyses to evaluate potential risks affecting future costs.

5. Stakeholder Communication:

Effective communication of EVM metrics to non-technical stakeholders is crucial for ensuring project success. Since EVM metrics are inherently technical, it’s important to translate complex data into simple, actionable insights. One effective approach is using visual dashboards with tools like Tableau or Power BI. These platforms allow project managers to present critical performance metrics such as Cost Performance Index (CPI) and Schedule Performance Index (SPI) in an easily digestible format, helping stakeholders quickly grasp the project’s status. Simplifying technical terms like “Variance at Completion (VAC)” into clear, straightforward language—such as “the expected cost overrun or savings at the project’s end”—makes the data more relevant and understandable for all involved.

In addition, maintaining frequent communication through regularly scheduled updates ensures stakeholders stay informed and aligned with project objectives. These updates, which can be conducted via meetings or reports, provide an opportunity to discuss project performance, address concerns, and adjust expectations if necessary. By keeping the communication channels open and consistent, project managers can foster transparency, build trust, and enhance decision-making, ensuring all parties are aligned on the path forward.

6. Corrective Actions:

When variances exceed acceptable thresholds, corrective actions are necessary to bring the project back on track. For example, if cost overruns are identified through the CV analysis, resources may need to be reallocated, or the schedule may need to be revised to prevent further delays. By taking proactive corrective measures based on EVM data, project managers can ensure that the project remains within its cost and time constraints, improving the likelihood of successful project completion.

By following these practical steps—defining a baseline, regularly collecting data, performing variance analysis, forecasting future performance, and implementing corrective actions—project managers can leverage EVM to maintain control over their projects, ensuring they stay within budget and on schedule.

Benefits of Using EVM Techniques

Earned Value Management (EVM) offers significant advantages by providing real-time insights into project performance, enabling data-driven decision-making. With continuous tracking of key metrics like Earned Value (EV), Planned Value (PV), and Actual Cost (AC), project managers can identify discrepancies between planned and actual progress early on. This visibility allows for informed decisions about reallocating resources, adjusting timelines, or revising project scopes to stay on track, preventing the need for drastic changes later in the project lifecycle. The result is improved agility and the ability to make timely course corrections, ultimately ensuring that the project remains aligned with its goals.

EVM also promotes enhanced accountability across project teams by increasing transparency in performance tracking. The methodology’s focus on monitoring progress at both the individual task and overall project levels fosters a culture of responsibility. As team members are made aware of the direct impact of their work on the project’s success, they become more engaged in meeting deadlines and managing costs. This visibility ensures that everyone involved is aligned with the project’s objectives and accountable for their contributions, leading to a more collaborative and focused effort toward achieving the desired outcomes.

Another key benefit of EVM is its proactive approach to problem-solving. By tracking variances in real-time, project managers can spot potential issues early and take corrective actions before they escalate. This early detection minimizes the risk of project delays, cost overruns, or resource mismanagement, helping teams maintain momentum and avoid major disruptions. The ability to quickly address issues as they arise ensures that the project stays on track and that problems are solved before they jeopardize the project’s success, reducing the likelihood of failure.

Additionally, EVM improves forecast accuracy, providing predictive metrics such as Estimate at Completion (EAC) and Variance at Completion (VAC). These metrics allow stakeholders to anticipate the project’s future financial and scheduling outcomes based on current performance trends. By using these forecasts, project managers can make adjustments to resources, timelines, and strategies, improving the accuracy of long-term predictions. This foresight is especially valuable in large, complex projects where deviations from the plan can become more pronounced over time. With EVM, project leaders can better anticipate potential challenges and adjust accordingly, ensuring that the project remains within budget and on schedule.

By leveraging these benefits, EVM enhances project control, drives better decision-making, and enables proactive management, leading to more successful project outcomes.

Practical Applications of EVM

Earned Value Management (EVM) is a highly effective technique employed across various industries to track and control project performance. In construction projects, EVM is particularly valuable for managing large budgets, ensuring that the work progresses as planned, and adhering to strict timelines. Given the scope of construction projects, with multiple contractors, subcontractors, and stakeholders, EVM offers an organized and systematic way to monitor the budget, schedule, and performance. By regularly assessing key metrics such as Earned Value (EV), Planned Value (PV), and Actual Cost (AC), project managers can make informed decisions to avoid cost overruns, schedule delays, and scope creep, ensuring that projects are completed on time and within budget.

In the aerospace and defense sectors, where projects are complex, high-cost, and typically have long timelines, EVM is indispensable for maintaining strict cost control and ensuring performance standards are met. Aerospace projects often involve cutting-edge technology, stringent regulatory requirements, and multiple stages of development, making EVM an essential tool for tracking progress at each stage. EVM helps stakeholders understand the cost implications of any delays or scope changes and allows for timely interventions to keep the project within its financial and scheduling parameters. For example, in defense contracts, where cost overruns and schedule slippage can have severe consequences, EVM enables better decision-making to avoid such risks and ensure the successful delivery of mission-critical systems.

In IT and software development, EVM has proven to be useful in both traditional waterfall methodologies and more flexible Agile or hybrid project environments. Although Agile focuses on iterative progress, integrating EVM in this context allows for a balance between maintaining project flexibility and ensuring financial oversight. By applying EVM to track both the completion of work and associated costs, teams can monitor the health of a project throughout each iteration or sprint. For example, the use of Earned Value (EV) in Agile sprints helps track the cost and progress of each user story or feature, providing a clear picture of whether the project is on track and within budget. This allows project managers to take corrective action early on if necessary, preventing cost overruns and ensuring that key deliverables are met on time.

Across these diverse industries, the use of EVM offers clear visibility into project performance, enabling timely adjustments and decisions to keep projects within their defined scope, budget, and schedule.

Challenges in Apllying EVM

Applying Earned Value Management (EVM) can present several challenges that organizations must address to realize its full potential. One of the most common hurdles is resistance to change. Many organizations hesitate to adopt EVM due to its perceived complexity and the disruption it may cause to established workflows. To overcome this, it’s effective to start with pilot projects that demonstrate the value of EVM. This allows teams to experience its benefits firsthand, building confidence in its capabilities before scaling it up across larger projects.

Another significant challenge is ensuring data accuracy. Inaccurate progress tracking or cost data can undermine the reliability of EVM results, leading to flawed decisions. To mitigate this risk, organizations should invest in training teams on accurate data collection methods, along with implementing automated tools to minimize human error. With a solid foundation of reliable data, EVM can provide more accurate and actionable insights.

Finally, interpreting EVM metrics correctly is essential, as misinterpretation can lead to misguided decisions that affect project outcomes. To address this challenge, providing comprehensive training for stakeholders on the meaning of key metrics—such as Cost Performance Index (CPI) and Schedule Performance Index (SPI)—is crucial. This ensures everyone involved understands the implications of the data and can make informed decisions based on the insights generated by the EVM process.

Conclusion

Earned Value Management is not just a set of formulas; it is a mindset for project management excellence. By leveraging tools like Primavera P6, Microsoft Project, and Deltek Cobra, and applying robust methodologies, project managers can achieve greater control over costs, schedules, and performance. While EVM requires effort to implement, its benefits far outweigh the initial investment, making it an indispensable tool for any organization aiming to deliver projects successfully.

About Rajesh Uppal

Check Also

The DARPA Phoenix Program: Redefining Satellite Design, Launch, and Assembly
